An international convenience retail company who works with construction contracting firms was using multiple systems for partners to complete work. Their existing process required users to work in three separate third-party applications, in addition to lots of manual work through spreadsheets, PDFs, and email. The process was intensive for all parties, and was in need of consolidation to streamline efforts and save time for everyone.
By creating a central system of engagement, our team built a unified application with automated workflows for internal teams and made it easier for job site workers to complete weekly status reports. The new application decreases the amount of effort required to manage work orders, purchase orders, and invoices for contractors and corporate teams.
For our requirements session, I wrote and assembled a presentation consisting of 50 questions about terminology, current state, and pain points.

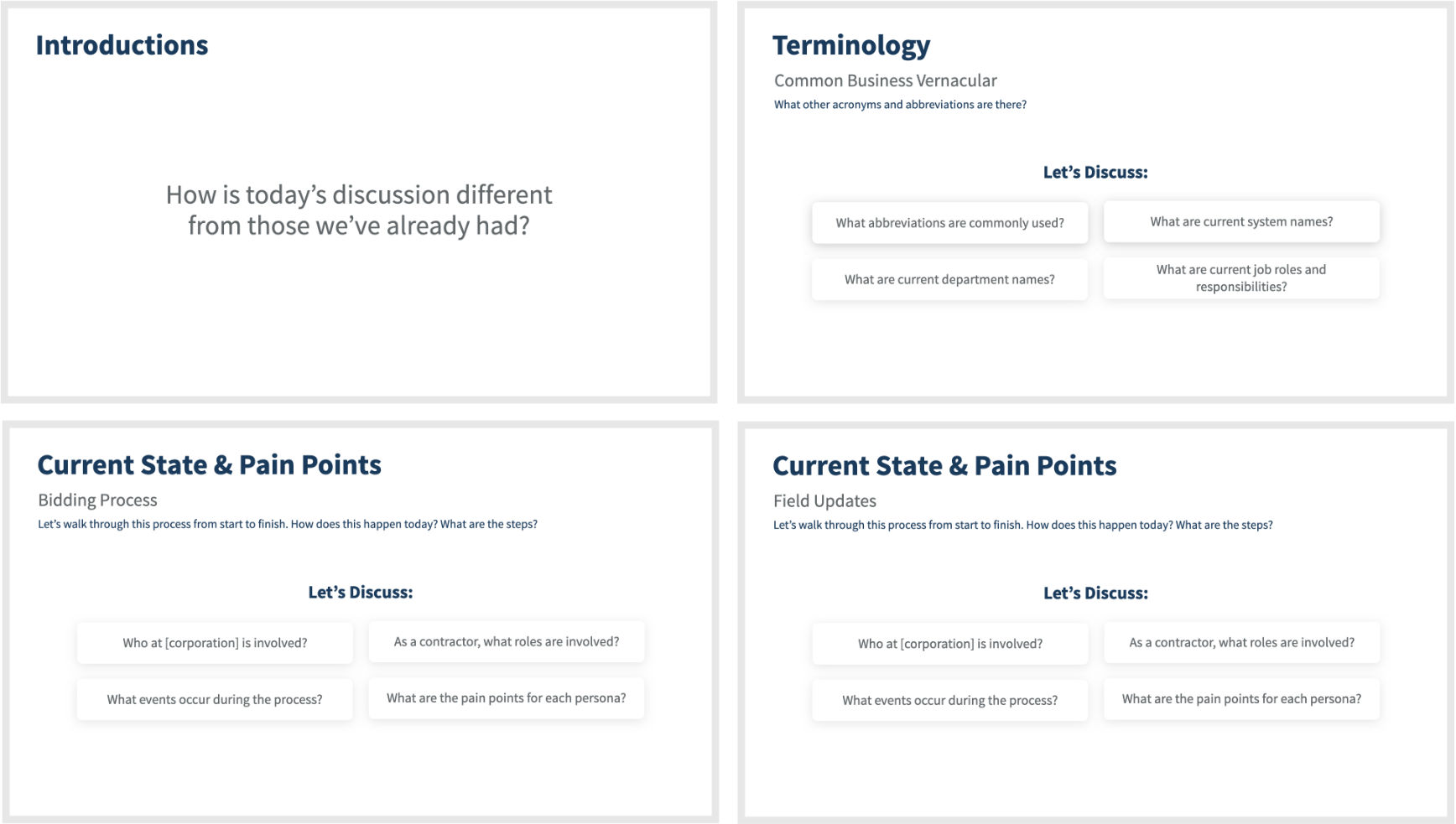

For project kickoff, our team held four working sessions with the client and users to understand how their existing workflows, processes, and third-party software applications were being used. To get ready, I wrote and put together a presentation with 50 questions about terminology, current state, and pain points across 8 different processes for construction management. After getting input from our group, I organized the presentation to help guide our conversations.
As UX Designer, I wanted to get a high level understanding of the different people, systems, and services in place that make up the workflows and processes in construction project management.
Our team had the opportunity to meet with a few users and see demos of how they were using multiple applications to get an understanding of the current state.
During the discovery sessions, our team had great conversations and learned a lot about the layers of people and processes required to take place for construction management projects. In a few pages, I documented what we learned and outlined current state, UX goals, and pain points for the corporation and general contractors.
We learned there were six processes to account for construction management. For each of these our team learned about what happens for each actor in the process:

After our discovery sessions, I went back through 20 pages of notes to highlight key takeaways and mapped six services and their processes that our team learned about. The blueprints show the journey of the general contractor and their interactions between the corporate construction manager, project management firm, corporate teams, and backstage actions and supporting processes along the way. Compared to a traditional blueprint, I also incorporated the biggest pain points while highlighting positive and negative moments where applicable.
Once a general contractor becomes an approved and fully onboarded vendor, they can begin bidding on jobs with the corporation.

Once a vendor is awarded the bid for a project, they receive and sign a contract with the corporation and are set up in various systems before beginning work.

On a weekly basis, a weekly progress report is generated for review with details about the project with status, schedule, risk, inspections, activities, and pictures of the job site.

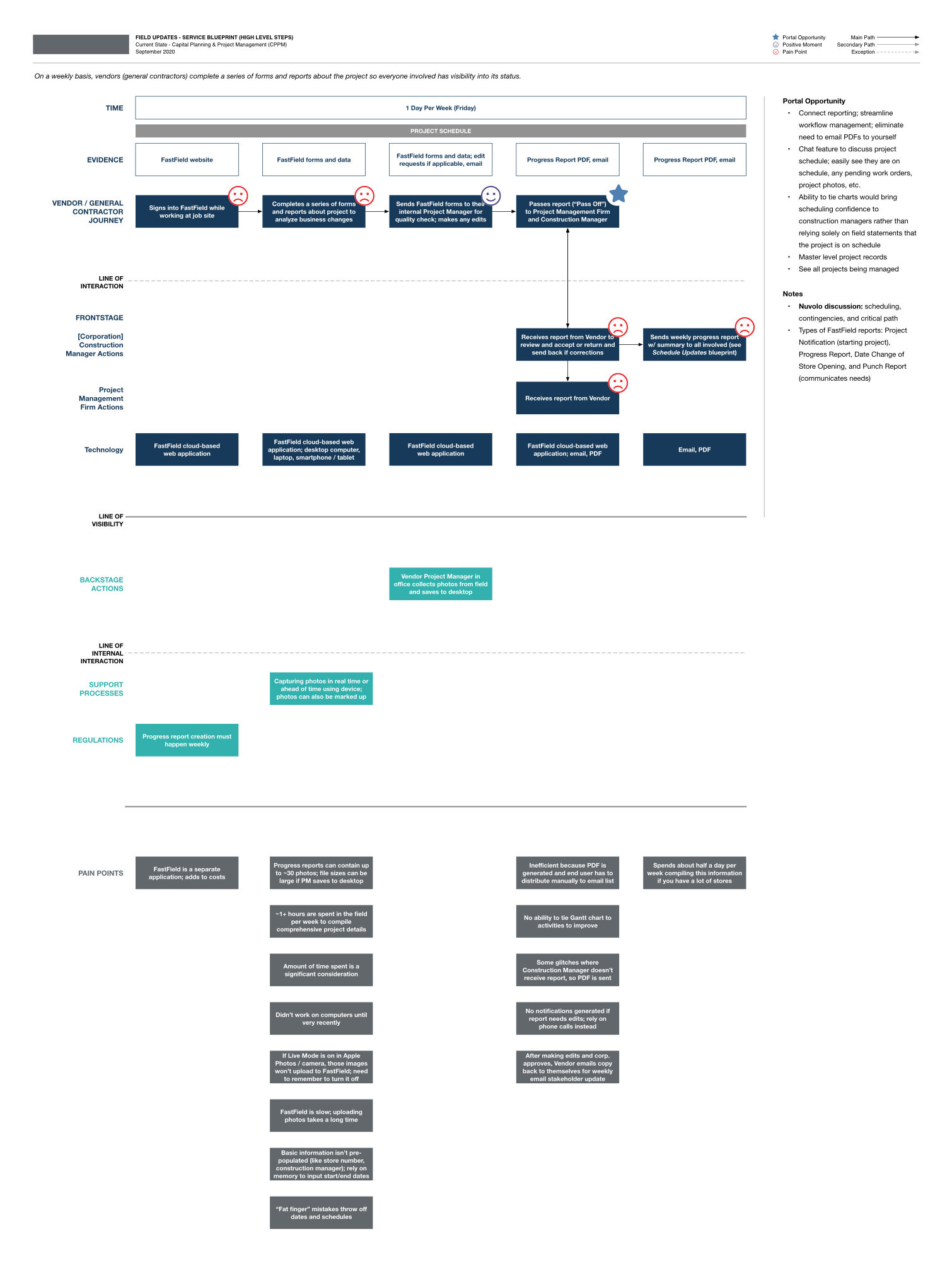

On a weekly basis, vendors (general contractors) complete a series of forms and reports about the project so everyone involved has visibility into its status.

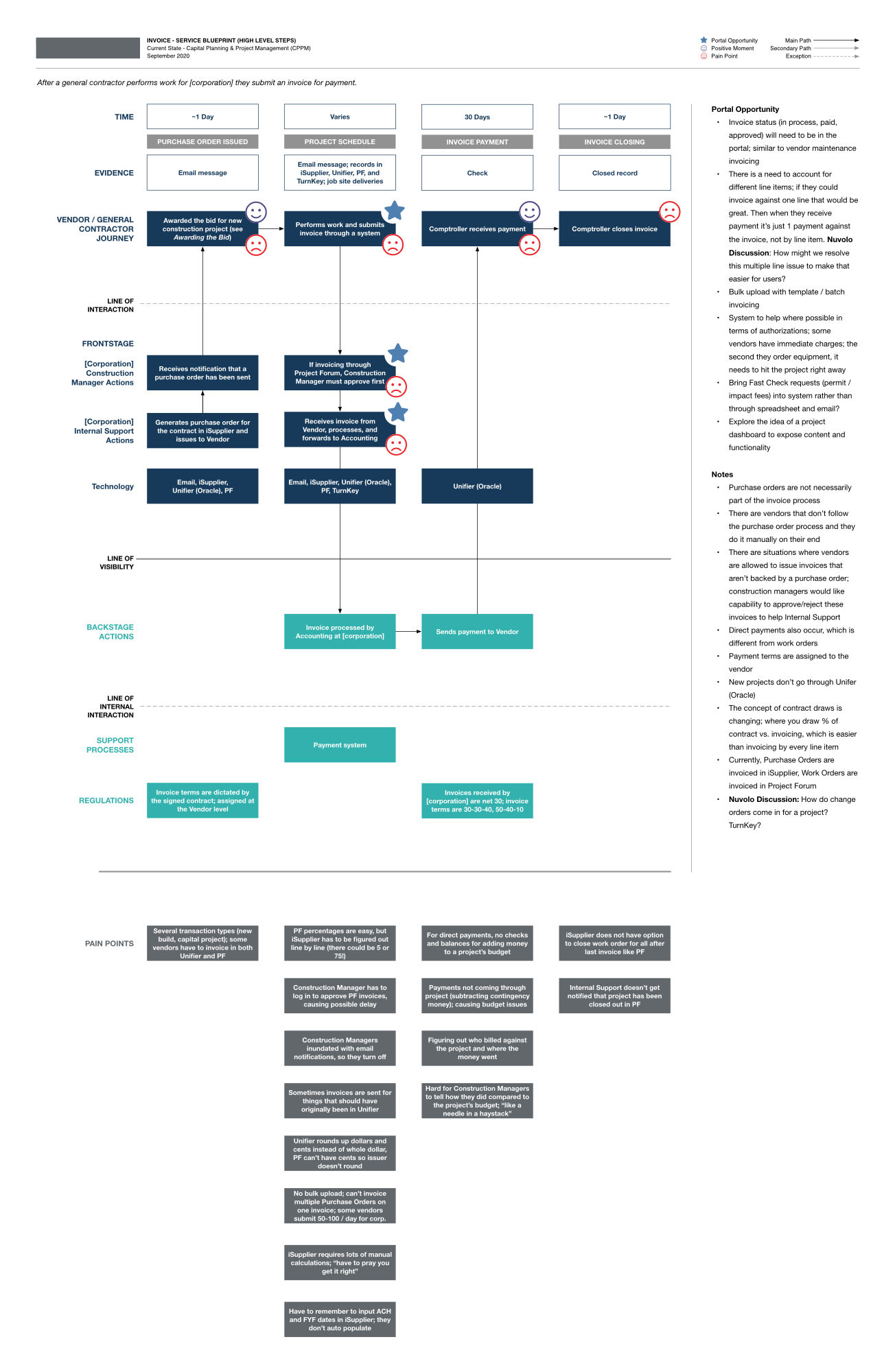

After a general contractor performs work for the corporation, they submit an invoice for payment.

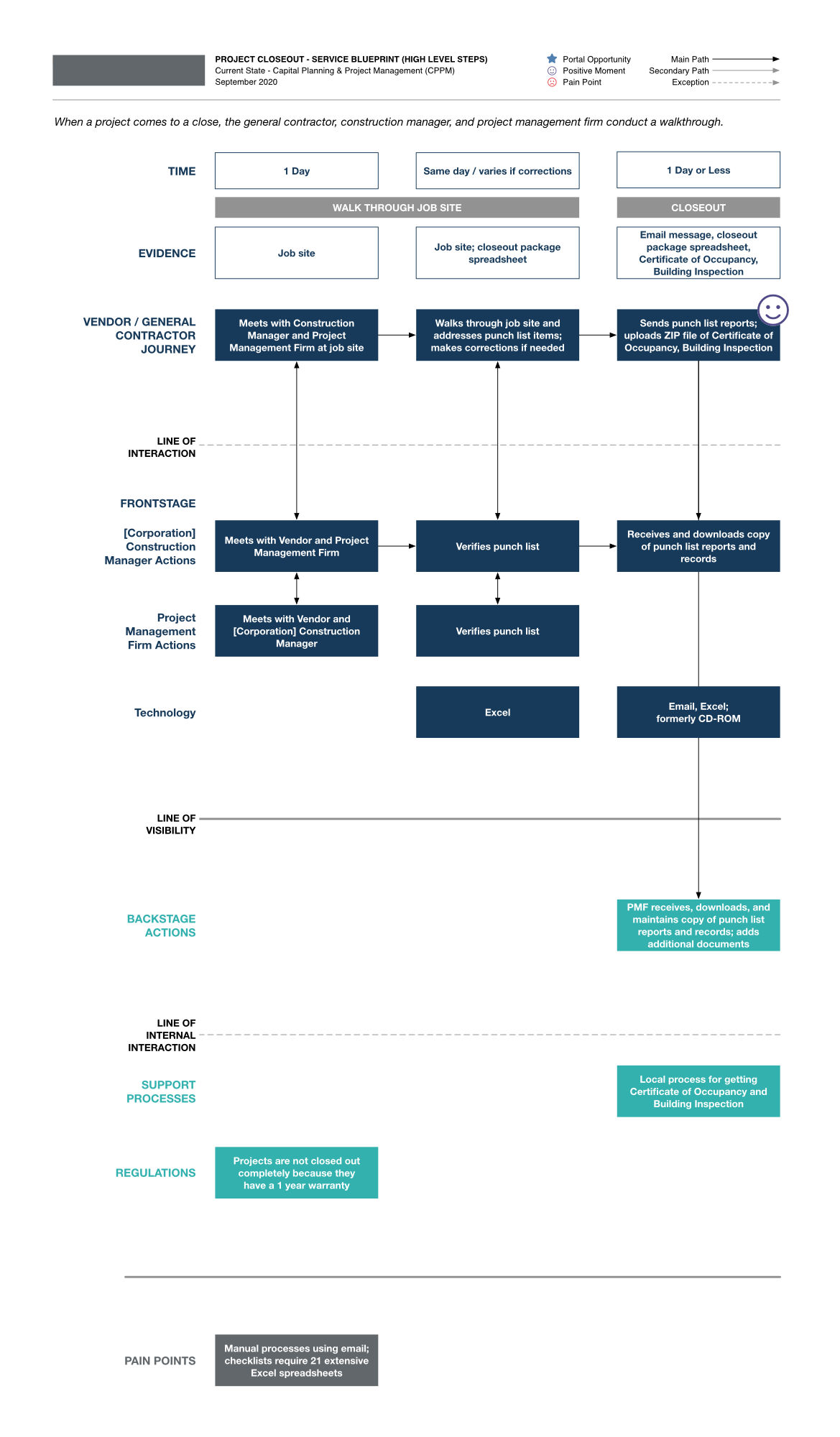

When a project comes to a close, the general contractor, construction manager, and project management firm conduct a walkthrough.
This application was the third in a series of connected systems we designed for the corporation. After meeting with construction users, analyzing notes, and referencing the personas I developed from the other applications, I created four primary personas and identified nine total. The four primary ones are: Comptroller, Job Site Worker, Construction Manager, and Procurement Representative. The other personas are Project Manager, Superintendent, Internal Support, Accountant, and Project Management Firm Agent. In a complex system, having the personas mapped out for easy reference helped cultivate empathy and keep our team organized when discussing usage scenarios.
“I need to increase my productivity, streamline my workflow, and feel empowered in software systems so I can quickly perform my tasks and provide the highest quality service.”

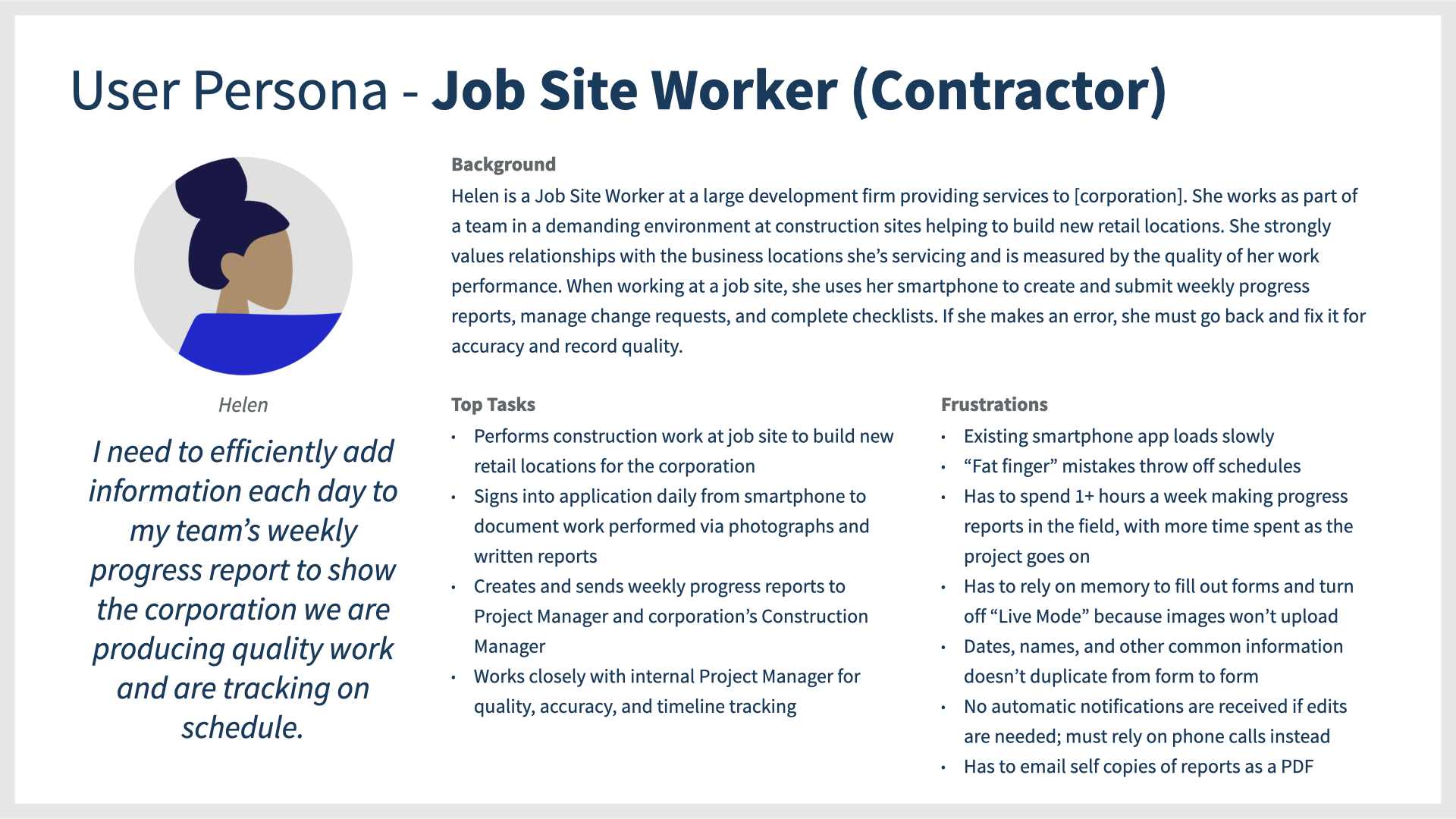

“I need to efficiently add information each day to my team’s weekly progress report to show the corporation we are producing quality work and are tracking on schedule.”

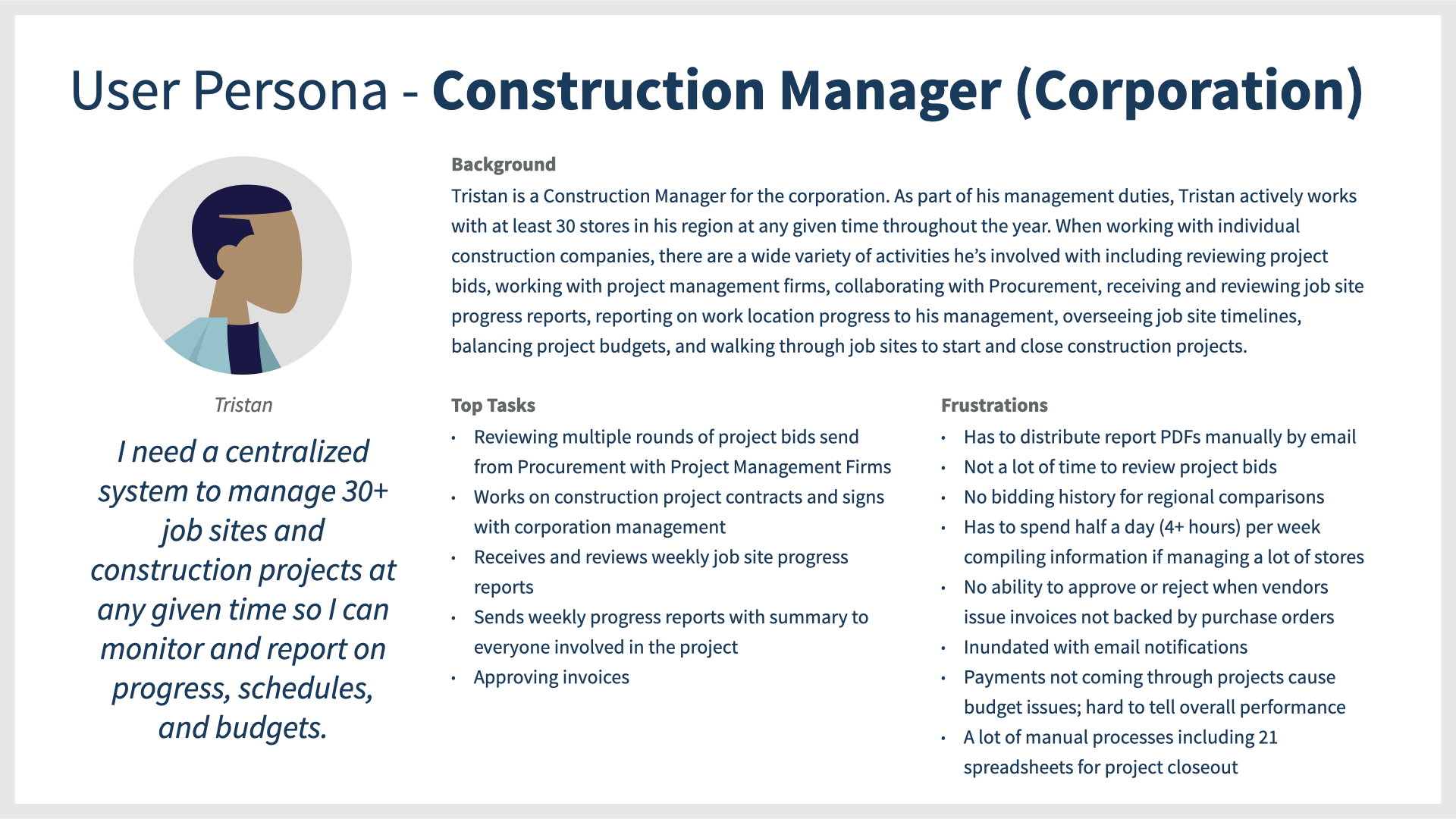

“I need a centralized system to manage 30+ job sites and construction projects at any given time so I can monitor and report on progress, schedules, and budgets.”

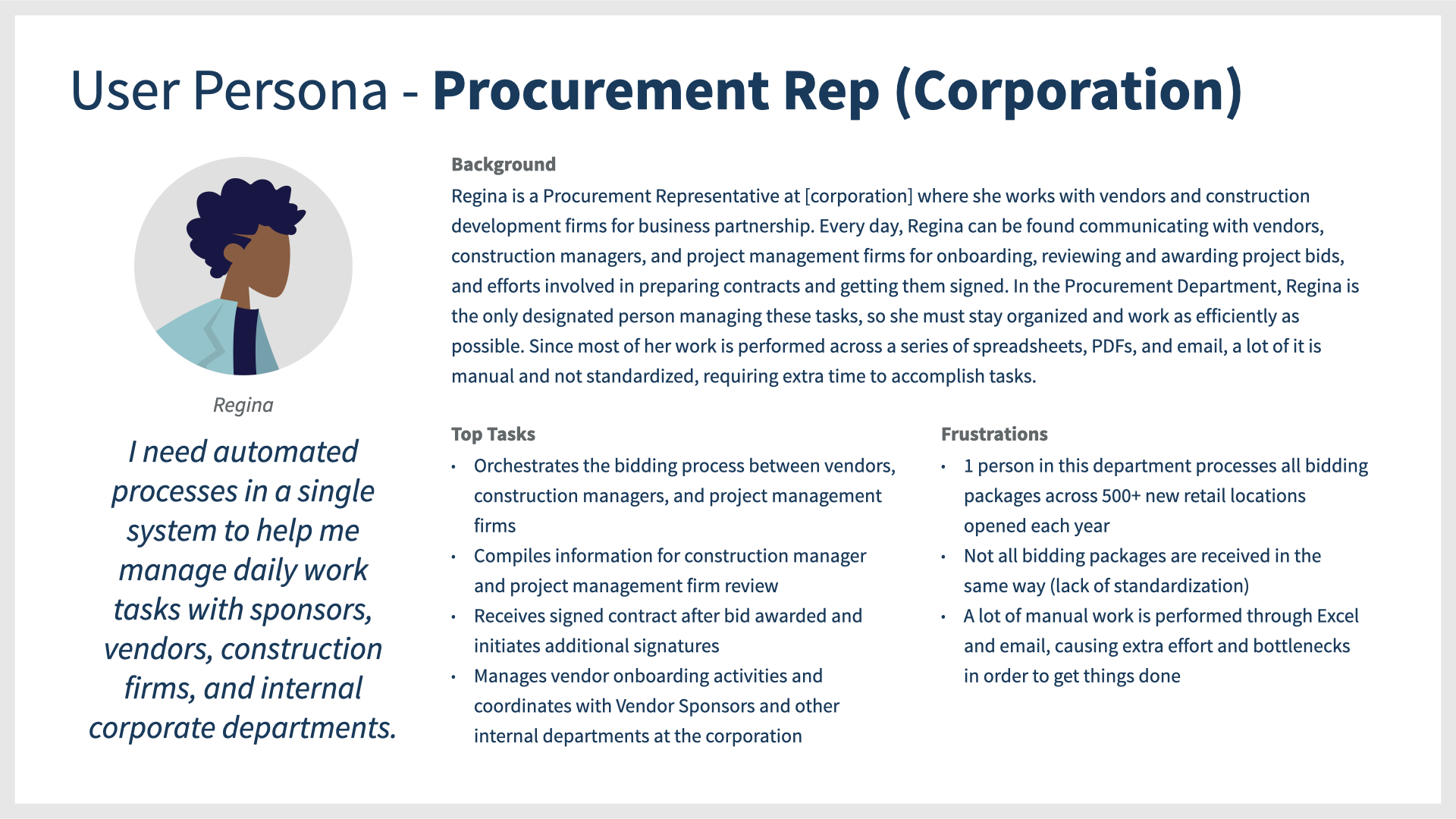

“I need automated processes in a single system to help me manage daily work tasks with sponsors, vendors, construction firms, and internal corporate departments.”

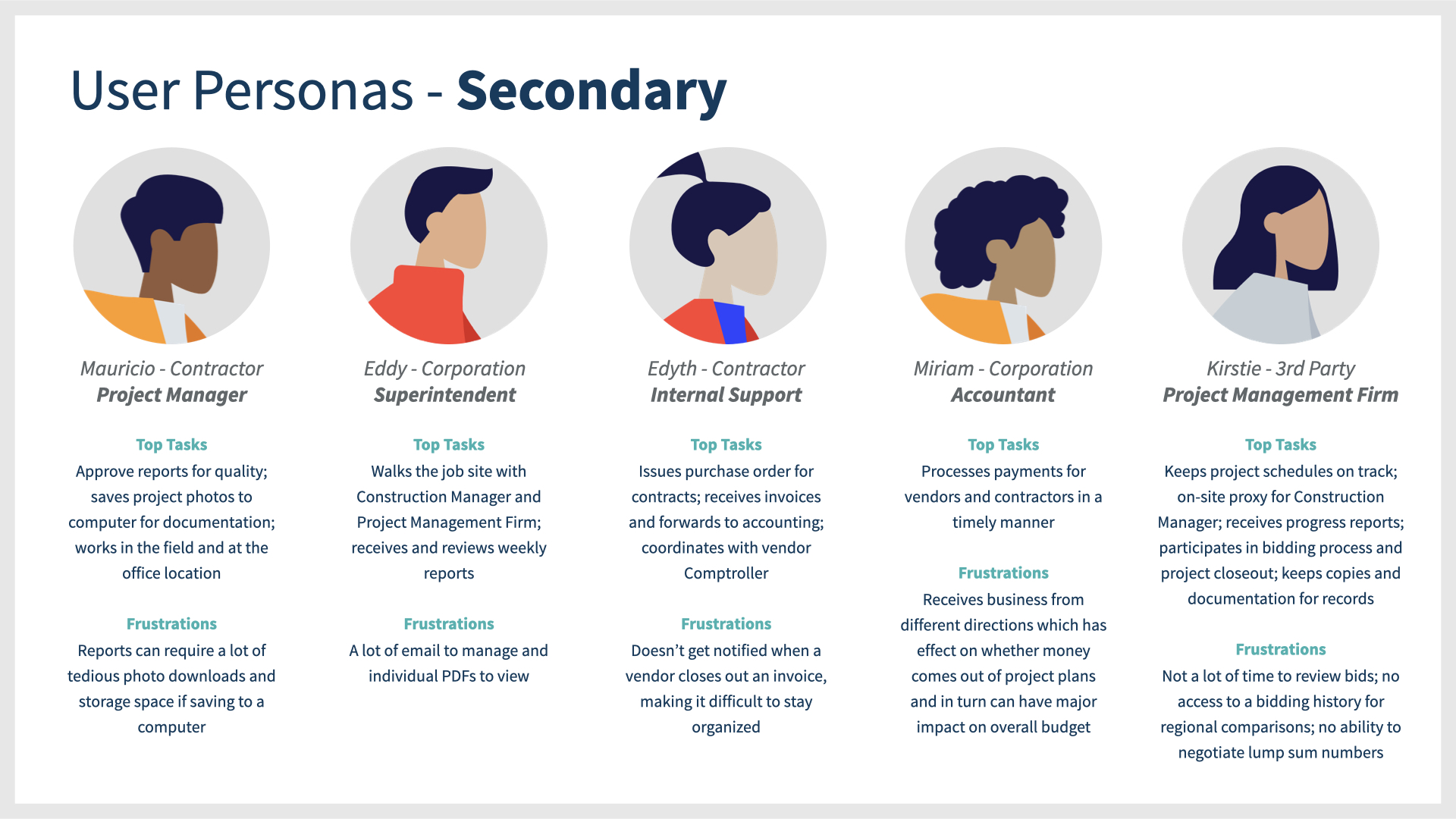

In a service system with multiple layers of systems and people, I discovered five additional personas that were mentioned in conversations. We didn’t take a deep dive into these, but I wanted to document them as a reference for the service blueprints.
To document core requirements for our stakeholders and help our Solution Architect, I created a detailed feature map that outlines different areas of content to be built in the portal. With the feature map, our Solution Architect wrote user stories and collaborated with external software engineers on technical requirements and backend workflows powering the system. Feature maps are used to account for the high level experience we are building for the client.
Since this application was uniting multiple complex processes and workflows, the Solution Architect and I worked closely together from the start. Over the course of four working sessions, we went through notes from the discovery sessions to discuss and sketch in real time how each section of the application might work. The focus of our sessions was to draw and map out the core concepts to gather initial feedback from our internal team before showing to our stakeholder.
After working internally, we met with our stakeholder to get their input and ask questions that came out of the ideation sketches. Our meetings were very productive and served as an excellent foundation to begin the wireframe stage.
Before I began sketching form layouts, I first took inventory of the types of forms and the information we needed to present within the interface.

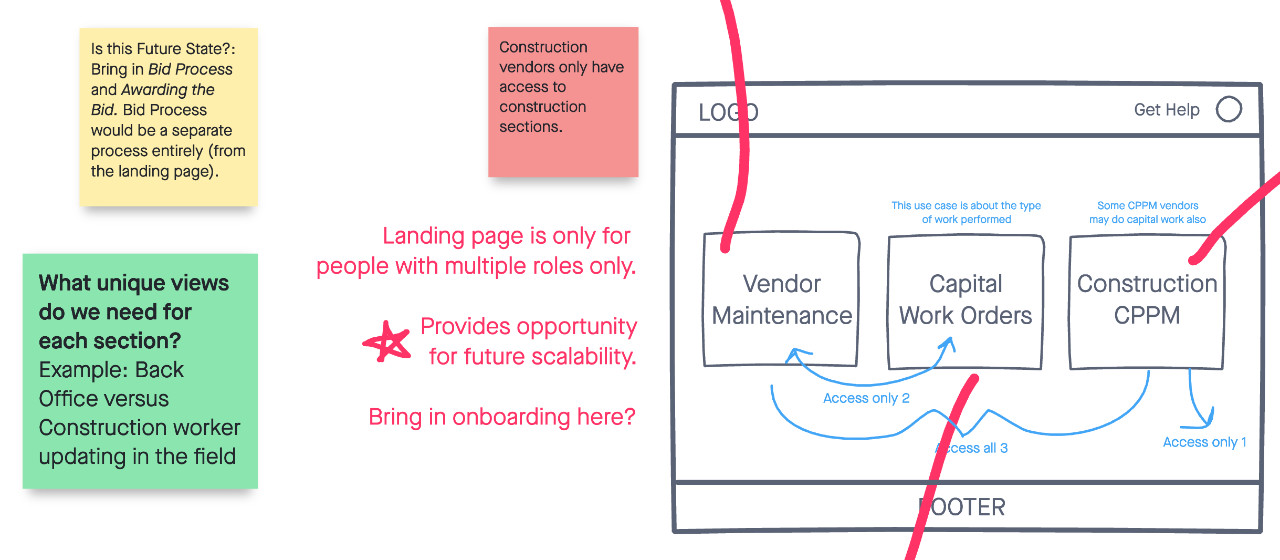

As part of the third phase of the project, we also needed to design a landing page that connects all three interfaces for ease of use to users that have more than one role.

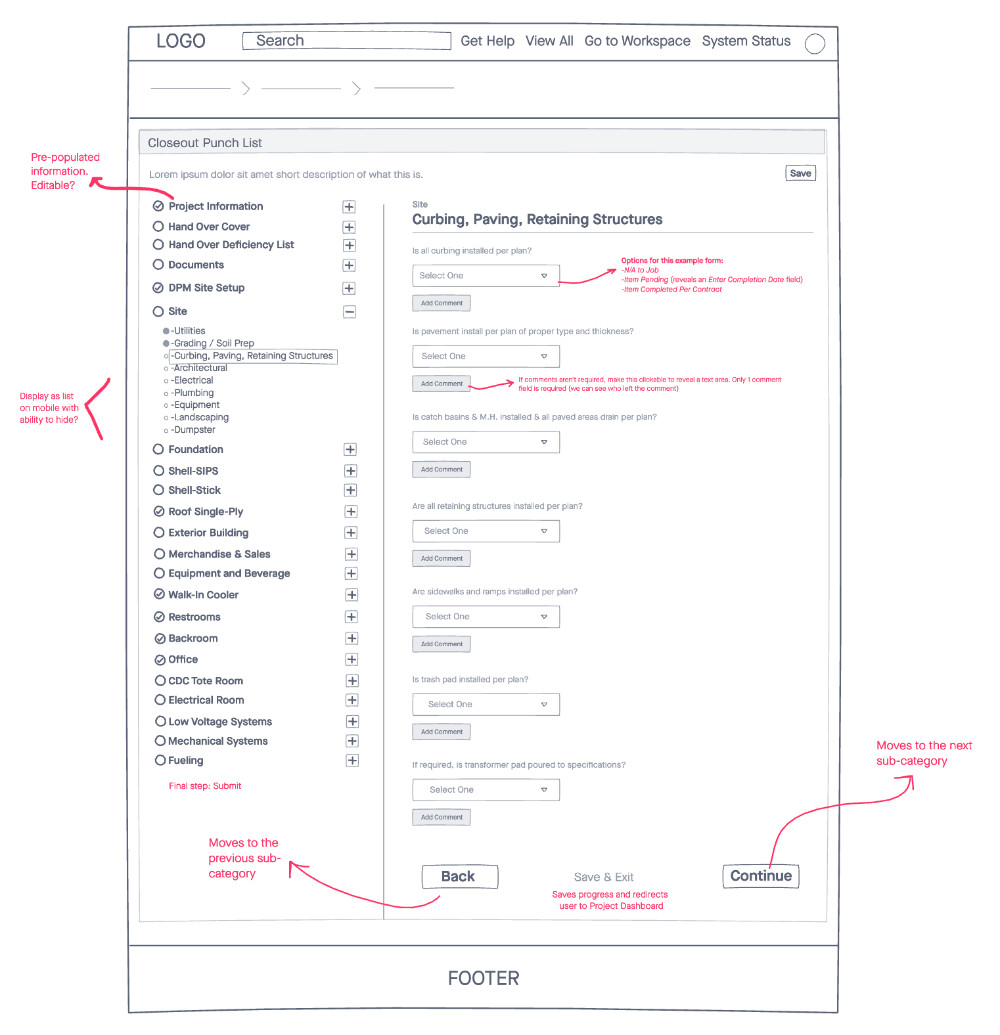

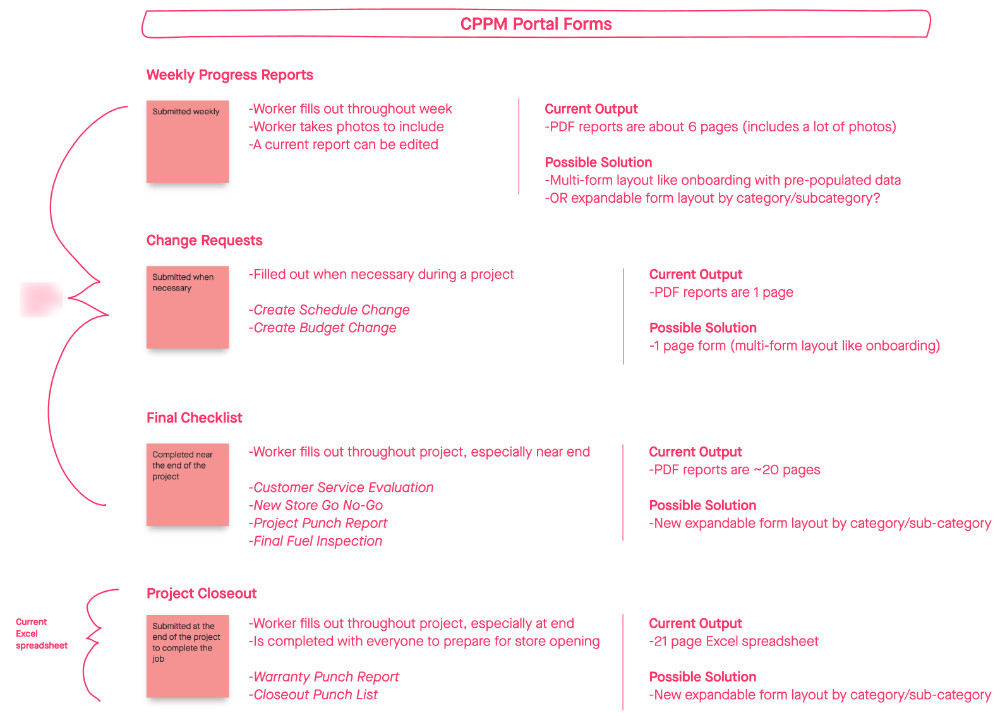

The closeout punch list originally existed in 21 spreadsheet tabs. For the interface, my goal was to design the most efficient way to capture a large amount of data.
Compared to the punch list, the progress reports capture less information but needed to be filled out sequentially.

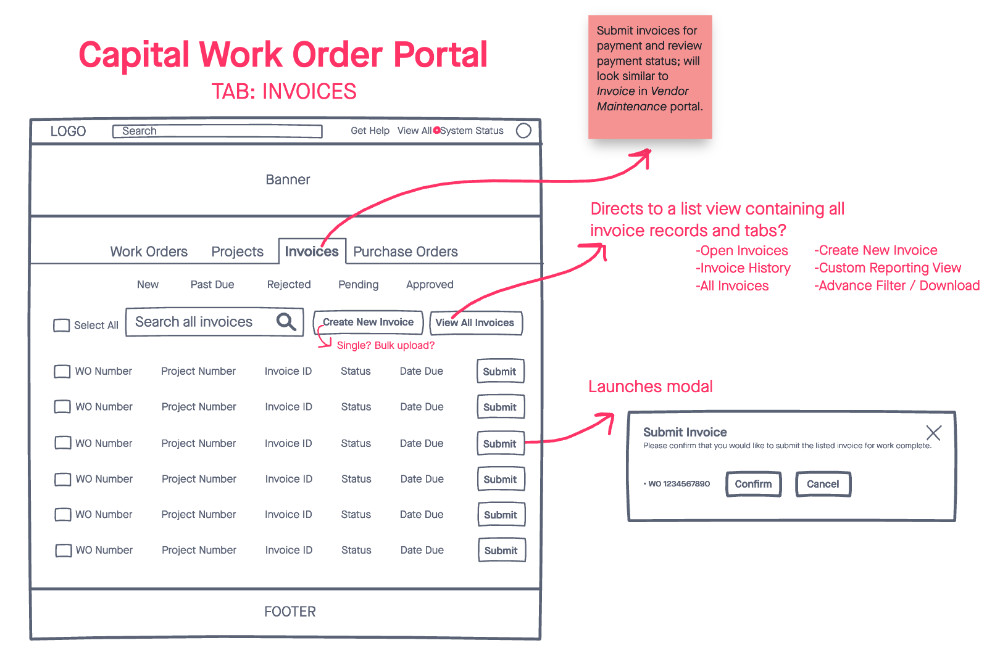

Designed for the job site worker, this section surfaces top tasks for the user that they perform regularly as part of their job. A lot of considerations and iterations were made.

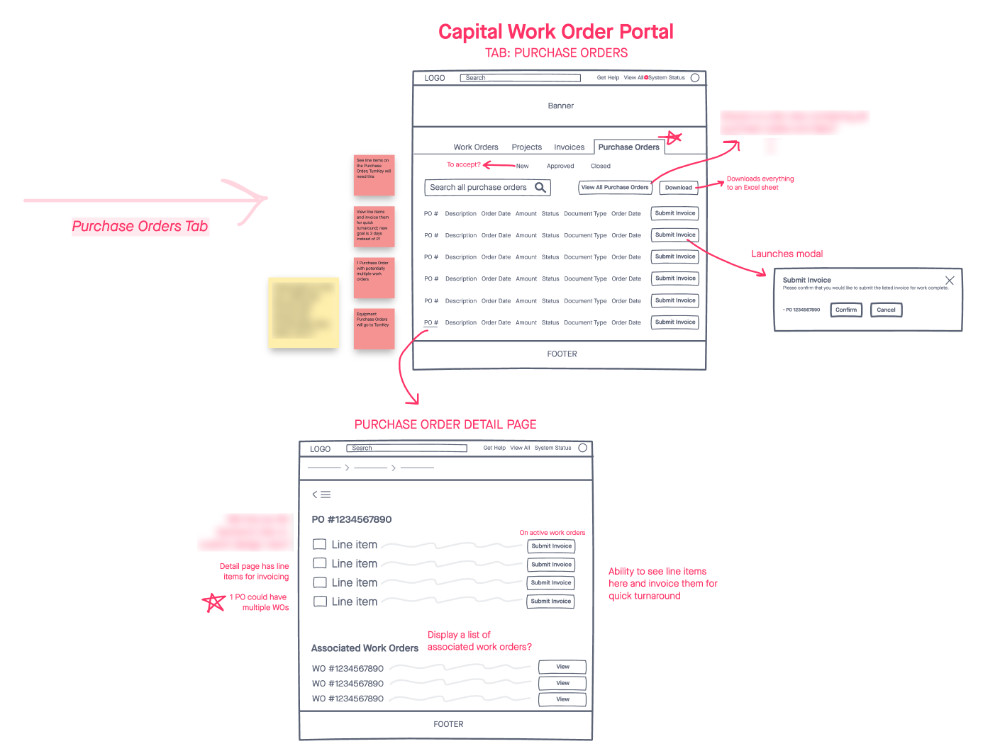

The Purchase Orders section provides the Comptroller with the ability to see line items and easily invoice them for quick turnaround.

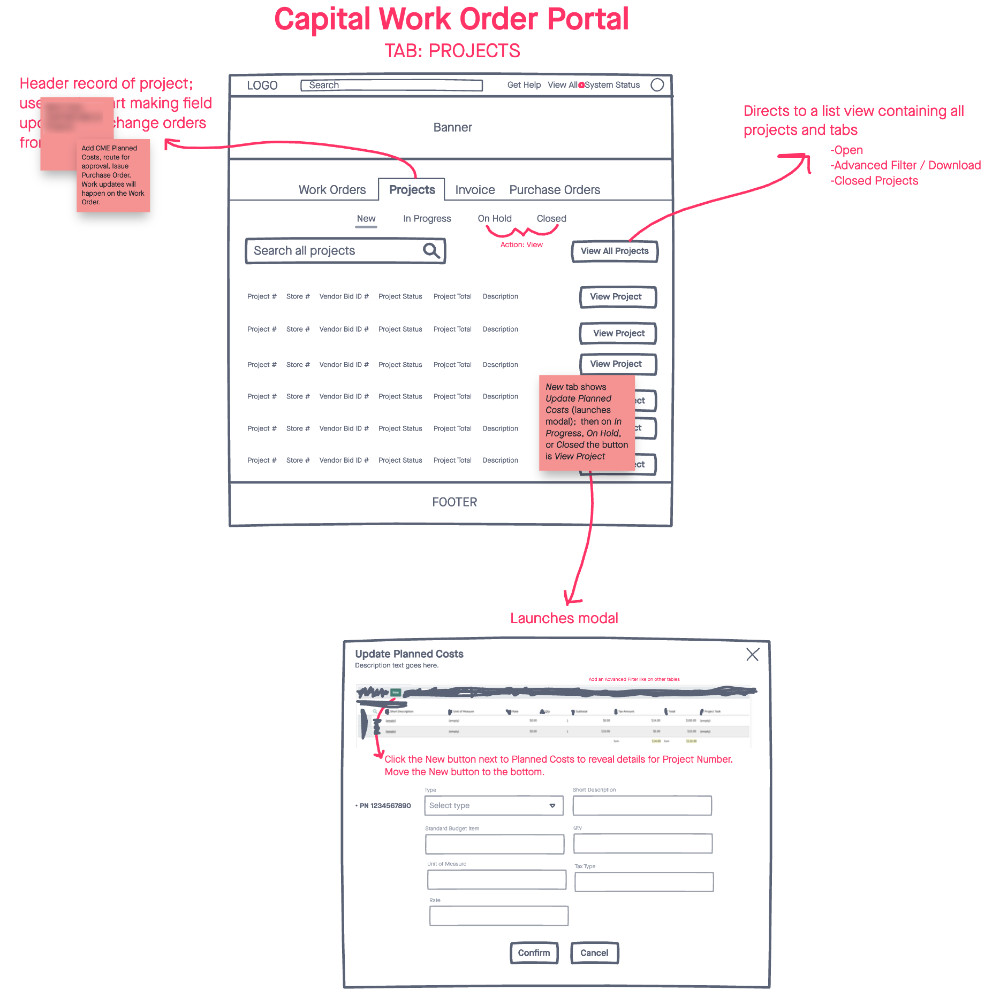

The Projects section helps users manage their current and past construction projects. From here, they can view records in one location with a complete project history.
From within the Invoices tab, the Comptroller can see new, past due, rejected, pending, and approved invoices along with complete details for each one. They can also easily submit invoices for payment that”s powered by an automated workflow that submits it to the corporation”s internal teams and accounting department.

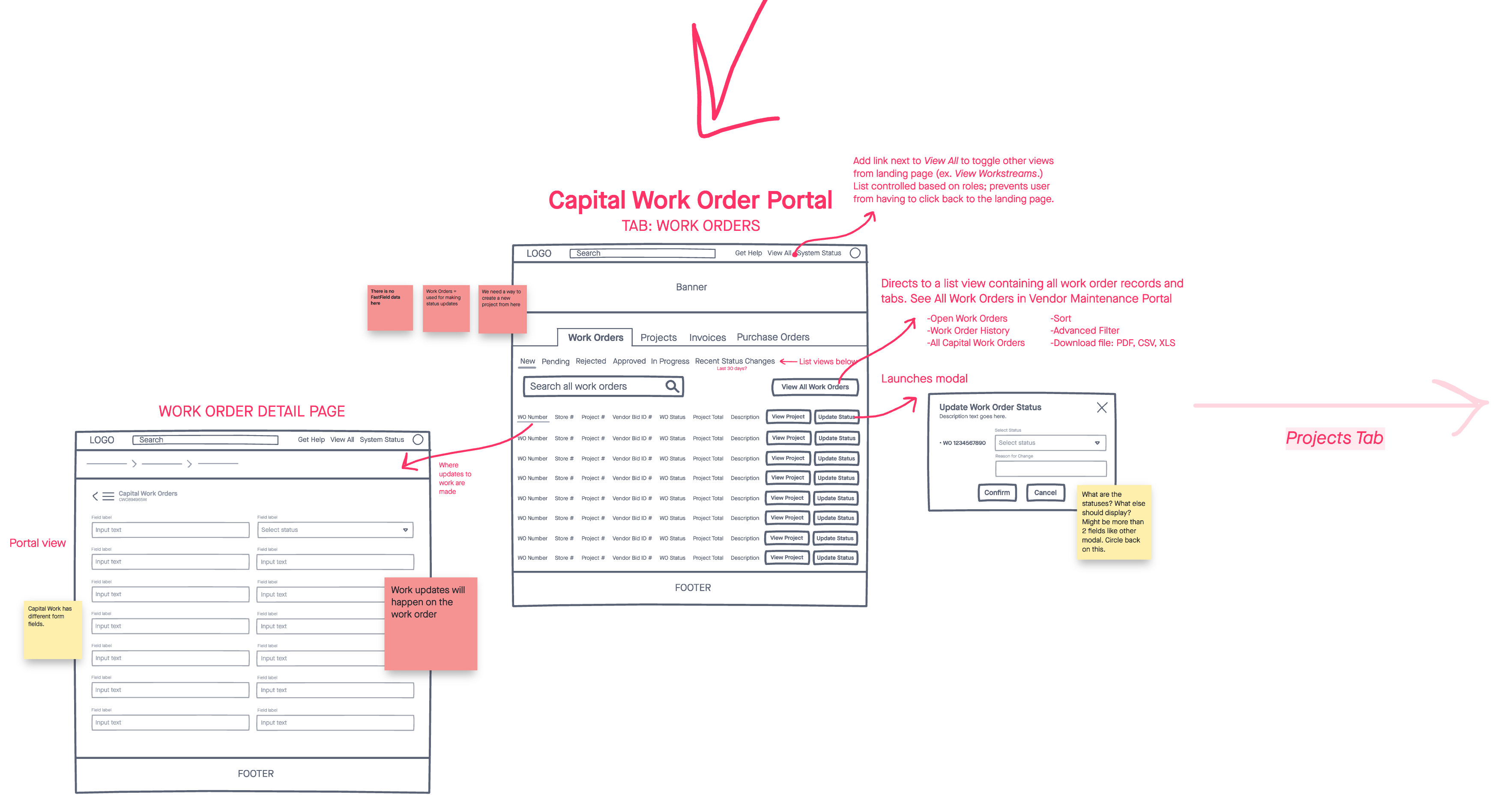

From the Work Orders tab, a user can see work orders that are new, pending, rejected, approved, in progress, or those that have a recent change in its status. Users can access their complete work order history, make updates, and make updates to their work.

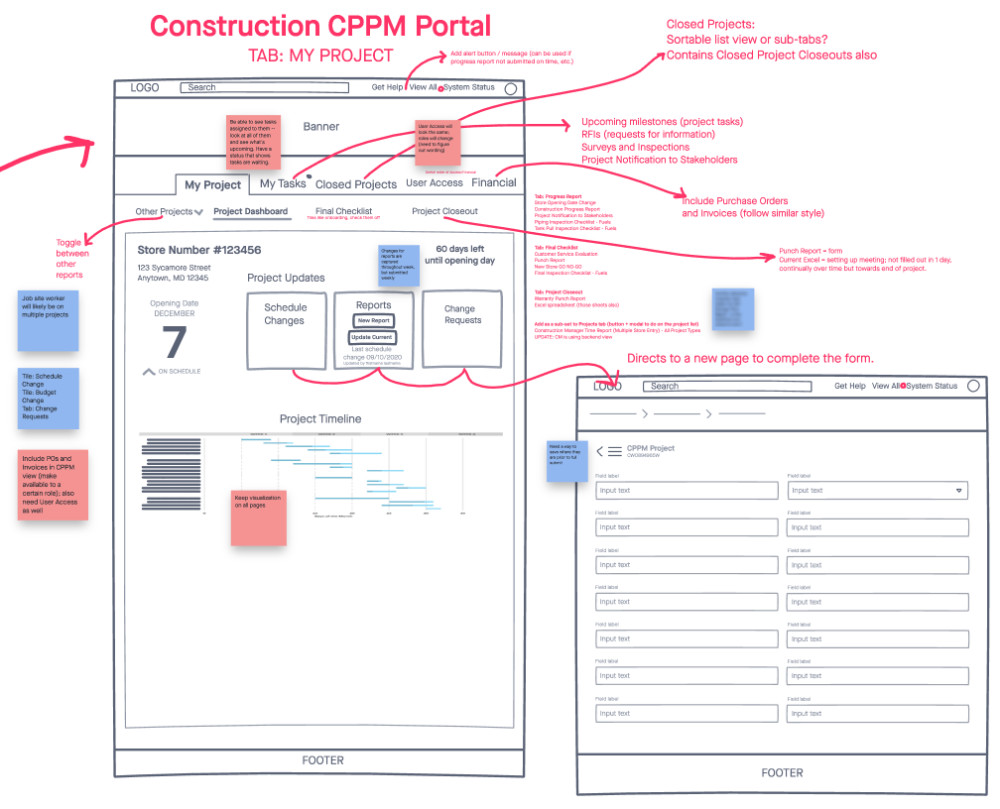

Using the low-fidelity sketches that were created and iterated on with our team and stakeholder, I moved into the interactive wireframing phase to visualize the user flow within the interface.
Since this application was the third of a series we developed for the corporation, we needed a way to unite everything for users with multiple roles. From a role-based landing page and within the application itself, a user can select what they are working on to focus on key content.
The My Project tab is a job site employee’s go-to screen for managing progress reports and change requests, as well as completing checklists necessary for project closing.

Within the Invoices section, users like Marcus (Comptroller) can manage everything related to construction payments including what’s new, past due, rejected, pending, and approved from payment. He can also create a new invoice and search all records.
Every week, a job site worker must complete a weekly progress report and submit it to the corporation’s construction manager for approval. On Monday a new report is created with details added daily before submitting on the week’s last work day.

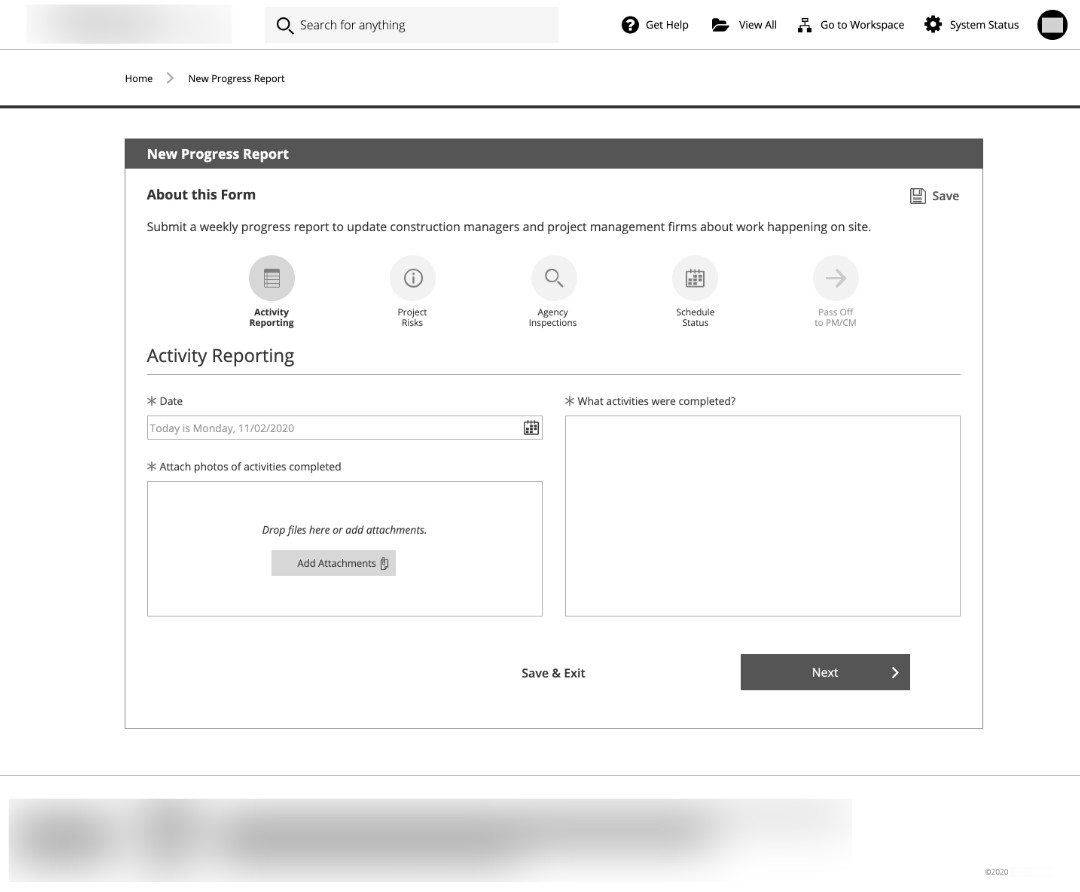

Throughout the work week, a job site worker updates the current progress report with that day’s activities. Using their smartphone, they attach photos of the work completed that day. They can also go back and edit a previous day if a mistake was made.

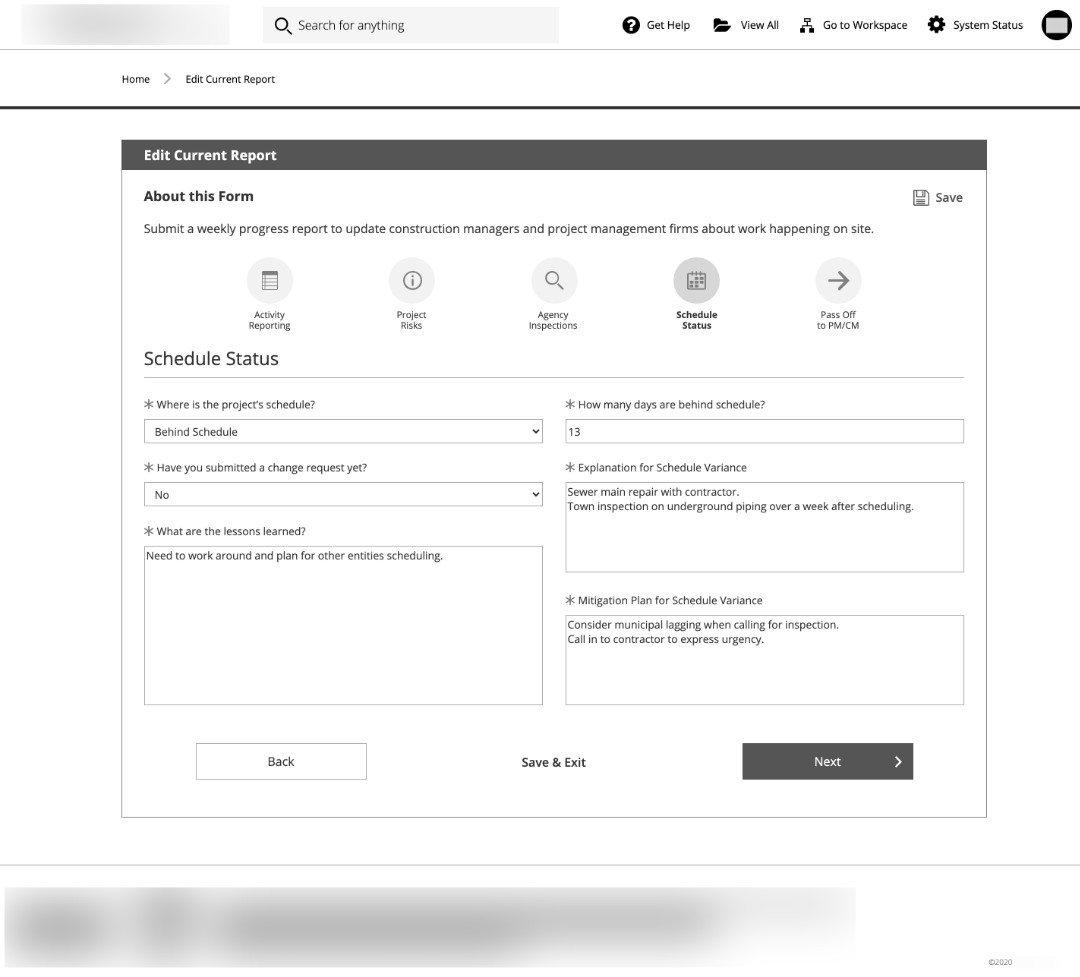

When editing a current progress report, a worker reports on the overall schedule status. If a project’s schedule gets off track, the reasons are documented here for updates.
At the end of the work week when the final progress day has been logged, the user needs to submit the report for review. They can pass off the report to their internal Project Manager who checks for errors or to the Construction Manager for review.
When the user is ready to submit that week’s progress report to the corporation, they receive a prompt asking them if they are ready to send it before it’s sent for review.
Near the completion of a construction project, the team completes a series of checklists to ensure codes are being met. Originally a 21-tab spreadsheet, this is now digitized for easy access, flexibility, and long-term record keeping.

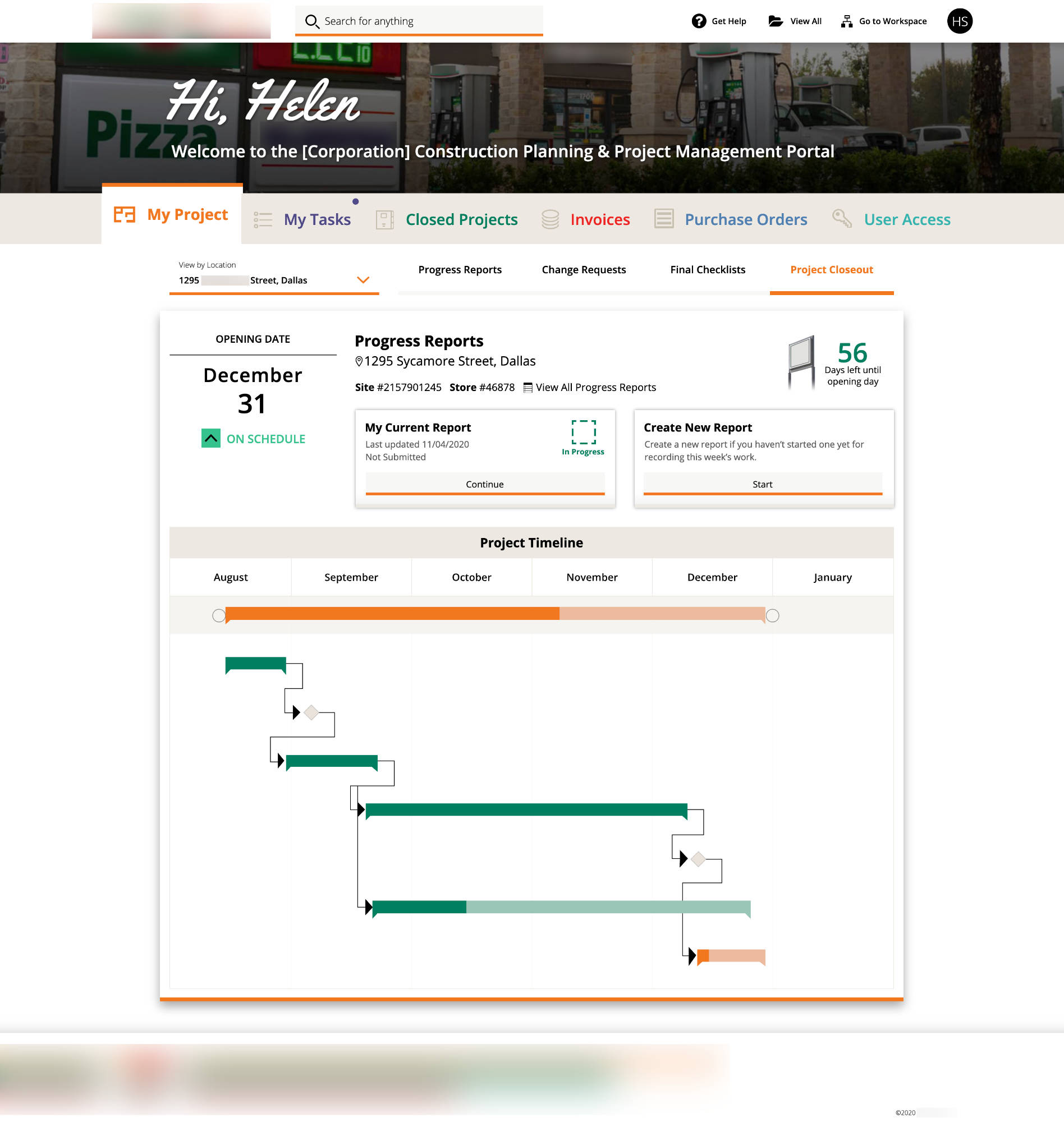

The landing page is a job site worker’s go-to location for working on progress reports, change requests, and checklists for construction projects while seeing the overall project timeline and whether or not they are on track.
The project management landing page directs users like Comptrollers towards the information they need to conduct business with the corporation including work/purchase orders, project management, and invoicing.
After making edits to the wireframes, I created an interactive UI design prototype to show how the construction management portal works. The design uses the corporation’s existing branding and was designed to match another connected interface in the series.
During development, I worked with our platform engineers to ensure quality production.
To see this design in action, watch the videos below demonstrating prototypes for desktop and mobile.
